Pillar 3 — ₹19,989 Cr


Shipbuilding Development Scheme (SbDS)


Capacity and capability development, plus credit risk coverage - the pillar that funds greenfield clusters and brownfield expansions directly. Valid for 10 years, till 31 March 2036.

Five Components of the Scheme


₹9,930 Cr

Greenfield Capacity

Capital support for new greenfield clusters

₹8,261 Cr

Brownfield Expansion

Expand existing shipyards' capacity

₹305 Cr

Capability - ISTC

India Ship Technology Centre

₹1,443 Cr

Credit Risk Cover

Pre/post-shipment & vendor default

₹50 Cr

Administrative

₹45 Cr scheme administration

Period of validity of scheme - 10 years (till 31 March 2036). Total pillar outlay ₹19,989 Cr.

Greenfield Clusters


Five Clusters Across India - Current Status


Five Clusters

In-principle approval has been granted for all five clusters. Structured introductions to any cluster SPV can be facilitated - write to invest.shipbuilding@gov.in.

greenfield explainer

YOUTUBE EXPLAINER

How India is building world-class greenfield clusters through 50:50 State-Centre SPVs, with 100% central capital assistance for common maritime infrastructure. Watch on YouTube ↗

Cluster Readiness - All Five States


Readiness Tamil Nadu Andhra Pradesh Gujarat Maharashtra Odisha
Cluster Site Thoothukudi Dugarajapatnam Kucchadi Dighi Kendrapara
Land Area 2,050 acres 3,488 acres 2,000 acres 2,000 acres 2,000 acres
Waterfront 2.4 km 2.1 km 2.7 km 3.0 km 2.5 km
Depth / Draft 5 m draft 13-15 m* 10 m within ~1 km 14 m* 12-15 m*
SPV Status SITCOP + VoCPA APMB + VPA GMB + DPA MMB + MbPA OMB + PPA
TEFR Availability
In-Principle Approval Granted Granted Granted Granted Granted
State Policy SB Policy Maritime Policy 2024 SB/SR Policy SB/SR Policy 2025 IPR 2022
Anchor Investor HD Hyundai Open Open 5+ MoUs signed Open

Depth planned post-dredging. In-principle approval has been granted for all five clusters.

Structured introductions to any cluster SPV can be facilitated to advance diligence on the states of your interest - write to invest.shipbuilding@gov.in.

Objective


Develop world-class shipbuilding clusters with shared infrastructure and advanced technologies to enhance competitiveness, drive economic growth and generate jobs - limited to one cluster per state, with preference for states offering land availability, single-window facilitation and maritime policy incentives.

Structure

SPV as a 50:50 JV between Central Govt (or entity) and State Govt (or its entity/agency)

Anchor Shipyard

At least 1 shipyard with minimum annual capacity of 0.5 million GT, achieved within 10 years of commissioning

External Connectivity

Trunk infrastructure facilitated by the Ministries of Road Transport & Railways, and/or the State Government

Eligibility Criteria


Cluster Capacity

~1.2 million GT/annum · ~2 km waterfront · ~1,000 acres for shipyards + ~1,000 acres for ancillary industry

Anchor Shipyard(s)

MoU with SPV / LoI with Board Resolution; binding undertaking not to repurpose for non-shipbuilding use for 10 years

SPV

Equal representation 50:50 JV; operates as concessionaire charging lease rent from anchor/participants

100% Upfront Grant - Five Eligible Categories


1 · Breakwaters

Tide-independent basins, wave breakers - coastal protection structures

2 · Channel & Basin Development

Capital dredging, land reclamation & area grading, turning basins

3 · Regional Capability Centres

Skill training, R&D, green shipbuilding technology & certification facilities

4 · Common Maritime Assets

Barges, heavy-lift ships, floating cranes, pontoons, tugs & auxiliary craft - registered under the SPV

5 · Internal Infrastructure

Site development, social infra, connectivity (roads/rail), utilities (water, power, drainage, sewage, communication, firefighting)

Land is additionally provided at near-zero value through nominal lease rentals by the State Government.

Roles & Mechanism


Central Government / Entity
  • 50% equity contribution
  • Facilitates external trunk infrastructure (MRTH / MoR)
State Government / Entity
  • 50% equity contribution · land transfer at ₹1
  • Last-mile connections, urban infra, single-window clearance
  • State incentives & schemes
SPV (50:50 JV)
  • Owns & develops land and common maritime infrastructure
  • Leases yard parcels & common infra to the anchor at nominal rental for 60+ years
  • O&M including lease collection & maintenance dredging
Anchor Investor (Shipyard)
  • At least 1 shipyard with ≥0.5 Mn GT annual capacity
  • Pays agreed lease rental
  • Invests in and operates yard-owned assets

Five coastal states are investor-ready: Tamil Nadu (Thoothukudi - SPV formed by SITCOP + VoCPA, IPA granted, anchor investor HD Hyundai), Andhra Pradesh (Dugarajapatnam - SPV formed by APMB + VPA, IPA granted), Gujarat (Kucchadi - SPV formed by GMB + DPA, IPA granted), Odisha (Kendrapara - SPV formed by OMB + PPA, IPA granted), Maharashtra (Dighi - SPV formed by MMB + MbPA, IPA granted). In-principle approval has been granted for all five clusters.

Brownfield Expansion

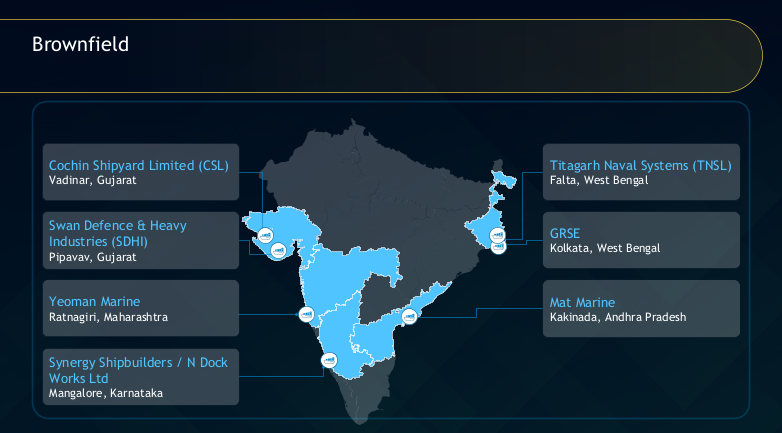

Where Brownfield Expansion Is Happening


Where Brownfield
4

IPAs Granted

₹2,045 Cr to be sanctioned

3

Applications Under Review

₹269 Cr

IN-PRINCIPLE APPROVAL GRANTED (4)
  • Titagarh Naval Systems (TNSL) — Falta, West Bengal · ₹516 Cr — IPA Granted
  • Swan Defence & Heavy Industries (SDHI) — Pipavav, Gujarat · ₹504 Cr — IPA Granted
  • Mat Marine — Kakinada, Andhra Pradesh · ₹105 Cr — IPA Granted
  • Cochin Shipyard Limited (CSL) — Vadinar, Gujarat · ₹920 Cr — IPA Granted
APPLICATION SUBMITTED (3)
  • Synergy Shipbuilders / N Dock Works Ltd — Mangalore, Karnataka · ₹35 Cr — Application Submitted
  • GRSE — Kolkata, West Bengal · ₹140 Cr — Application Submitted
  • Yeoman Marine — Ratnagiri, Maharashtra · ₹94.3 Cr — Application Submitted

Open to every existing Indian shipyard - unlike greenfield clusters there is no one-per-state limit. Grant released in four milestone tranches of 15% - 30% - 35% - 20%.

brownfield

YOUTUBE EXPLAINER

The scheme that lets existing Indian shipyards expand - 25% of approved project cost as capital assistance, up to ₹1,500 Cr per yard. Watch on YouTube ↗

Brownfield Projects Approved & Under Review - 7 Shipyards


4

IPAs Granted

₹2,045 Cr to be sanctioned

3

Applications Submitted

₹269 Cr under review

₹2,314 Cr

Combined Value

Across 7 shipyards

# Shipyard Location Investment (₹ Cr) Status IEA Allocated Scope of Project
1 Titagarh Naval Systems (TNSL) Falta, West Bengal 516 IPA Granted Yes (KOMAC) New yard at Falta - 10-12 vessels up to 160 m/yr
2 Swan Defence & Heavy Industries (SDHI) Pipavav, Gujarat 504 IPA Granted Yes (Lloyd's) Phase 1: Goliath crane & ELL crane
3 Mat Marine Kakinada, Andhra Pradesh 105 IPA Granted Yes (AECOM) Shipbuilding / ship-repair infrastructure incl. slipways for +1,000 GT/yr
4 Cochin Shipyard Limited (CSL) Vadinar, Gujarat 920 IPA Granted Yes (Jacobs) Ship repair facility at Vadinar, jointly with Deendayal Port Authority (DPA)
5 Synergy Shipbuilders / N Dock Works Ltd Mangalore, Karnataka 35 Application Submitted To be allocated Upgradation of Mangalore facility - jetty, basin dredging, covered fabrication units
6 GRSE Kolkata, West Bengal 140 Application Submitted To be allocated Modernisation of 6 jetties incl. RCC pile jetties, bank protection and allied utilities
7 Yeoman Marine Ratnagiri, Maharashtra 94.3 Application Submitted To be allocated Brownfield expansion at Ratnagiri incl. channel dredging, slipway and jetty upgrades, modular fabrication, cranes and automation

Only projects with in-principle approval granted or an application already submitted to DGMA are listed. In-principle approval carries no financial commitment - capital assistance is sanctioned only at final approval. Investment figures are as declared by applicants and remain indicative until appraisal.

Capital assistance is 25% of the Approved Project Cost, capped at ₹1,500 Cr per shipyard, released in four milestone tranches of 15% - 30% - 35% - 20%.

SbDS Brownfield Expansion Scheme


Facilitates capacity augmentation, modernisation & technological upgradation of existing shipyards to enhance competitiveness and efficiency.

Existing Indian Shipyard

Operational ≥3 years before 24 Sep 2025

Expansion Anywhere in India

Capacity, modernisation & technology upgrade

25% SbDS Brownfield Grant

Of eligible project cost

Up to ₹1,500 Cr per shipyard

Milestone-based disbursement of grant in 4 tranches - 15% - 30% - 35% - 20%.

Eligibility Criteria


Track Record & Land
  • Incorporated & operational ≥3 years before 24 Sep 2025
  • Land owned outright, or leased ≥15 years from application date
  • Lease must be in place before In-Principle Approval
Must Hold ≥3 of 5 Core Assets
  • Dry berthing (dry dock / slipway / floating dock / shiplift)
  • Wet berthing (jetty / pier / wharf)
  • Metal fabrication / hull erection · material handling · waterfront access
Works & JVs
  • Works commence only after In-Principle Approval
  • Completion within 6 years of Final Approval
  • Subsidiaries/JVs eligible if applying yard holds ≥50% (or ≥33.4% in 3+ partner JV)

Eligible Components


1 · Slipway

Launch infrastructure

2 · Dry Dock

New or expanded dry-docking capacity

3 · Shiplift

Vessel transfer systems

4 · Channel & Basin Development

Dredging & access improvements

5 · Pier / Jetty

Berthing infrastructure

6 · Automation & Digitalisation

Production technology upgrades

7 · Cranes

Material handling capacity

8 · Block / Modular Fabrication

Modern construction methods

9 · Floating Dock

Mobile docking capacity

Excluded: Maintenance & repair · Cost of land · Pre-approval projects

Any facility not listed is reviewed by the Implementing Agency (IA) and submitted to NSbM for case-by-case approval.

Approval & Fund-Release Process


Application Preparation

Verify eligibility (≥3 of 5 core assets); prepare DPR (Annexure I) and Business Plan; obtain environmental & statutory clearances; submit online with affidavit/indemnity bond and board resolution.

In-Principle Approval

No financial commitment yet. ≤₹100 Cr: DGMA grants directly. >₹100 Cr: DGMA reviews and refers to NSbM.

IEA Appraisal & Financial Closure

Independent Evaluation Agency conducts a physical site visit, assesses technical feasibility, cost reasonableness, financial viability & regulatory compliance, then issues a TFAR to the Project Appraisal Committee (PAC). Shipyard demonstrates financial closure (equity + debt covering 75% of APC) and submits a security instrument.

Final Approval

Sanction letter issued. ≤₹100 Cr: DGMA approves on PAC recommendation. >₹100 Cr: DGMA → PAC → NSbM.

Milestone-Linked Fund Release - T1 to T4

15% - 30% - 35% - 20% — T1 (15%) on work-order issuance for ≥50% of approved project cost; T2 (30%) at 15% physical progress; T3 (35%) at 75% of T1 utilised; T4 (20%) on 100% project completion certificate & 100% of T1-T3 utilised.

Capability - ISTC


India Ship Technology Centre (ISTC)


ISTC is incorporated as a Section 8 company, with budget allocation sought and received for BE 2026-27 and its CEO and other functionaries being appointed. A steering committee of industry stakeholders - including CSL, IMU, IMDA and SAI - has been set up to initiate SaaS procurement, run a gap analysis of existing testing infrastructure, develop R&D support guidelines, and propose additional testing infrastructure based on that analysis.

Software as a Service (SaaS)


ISTC is mandated to centrally procure design software and offer it to industry at nominal cost - extensive discussions with providers have identified software across three categories:

Design

CADMATIC · Ship Constructor · NAPA

Analysis

ANSYS · ANSYS AQWA · STAR CCM · ORCAFLEX · CAESAR II · SACS

Production

TTM · SolidWorks

Credit Risk Cover


SB Credit Risk Cover - ₹1,443 Cr Corpus


Operationalises the ₹1,443 Cr allocation under SbDS to provide financial protection to Indian shipyards against key risks in domestic and export shipbuilding projects, at nominal premiums.

1 · Pre-Shipment Insurance

Buyer's default - protects the shipyard if the buyer cancels or defaults during construction, covering incurred costs & lost profits

2 · Post-Shipment Insurance

Payment default - covers non-payment after vessel delivery, including commercial disputes and applicable political risks

3 · Vendor Default Insurance

Supply-chain risk - covers losses from a vendor's failure to supply critical equipment, protecting advance payments made by the shipyard

Fund Access & Disbursement


Fund Access & Agencies

Corpus centrally managed by DGMA / SMFCL; access granted to Government-owned entities/PSUs - NIA & ECGC - via Letter of Nomination

Annual Tranches

Released in annual tranches linked to policy uptake, claims processed and utilisation efficiency; mid-year top-up available on request to NSbM

Premiums

Kept nominal - primarily to cover agency operating & training costs. GoI's seed corpus absorbs all risk payouts

Source: Implementation Guidelines for Credit Risk Covers under SbDS, MoPSW / DGMA.
